Construction

Construction updates

Stay Informed



Destination Brisbane Consortium is the project developer responsible for the design, approval and construction of Queen’s Wharf Brisbane.

Queen’s Wharf Brisbane is the largest construction project in Queensland and at its peak will employ nearly 2,000 people.

The consortium has chosen to break the construction down into multiple contractors for different work packages. These include:

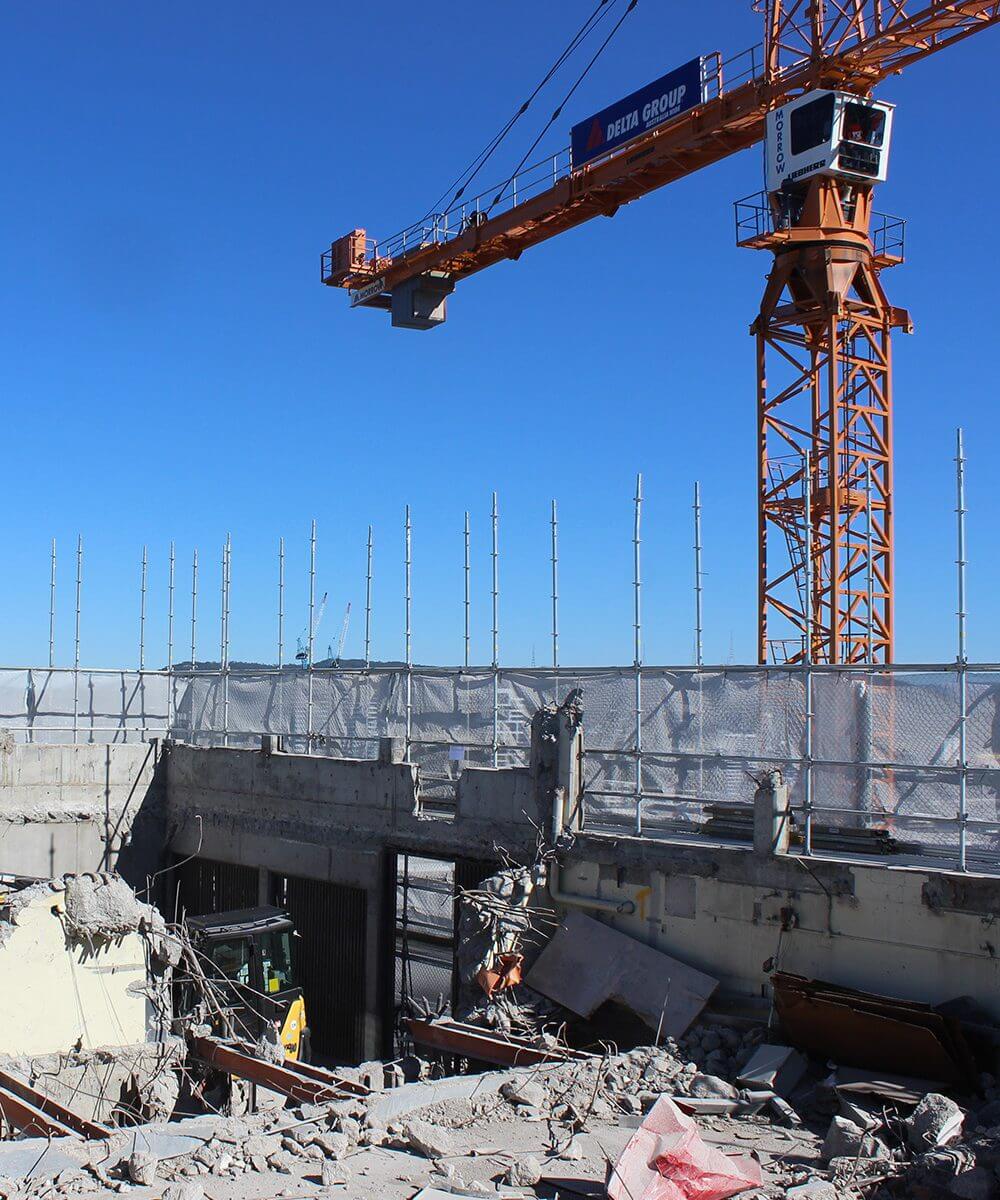

  • Demolition (completed December 2017)
  • Excavation (completed July 2019)
  • Mangrove Walk, Bicentennial Bikeway and Waterline Park (completed September 2019)
  • The Landing structural works (completed September 2020)
  • Neville Bonner Bridge (started March 2020)
  • Shell and core construction of Integrated Resort Development (started July 2019)
  • Internal fit-out of Integrated Resort Development (started July 2021)
  • Public realm including Bicentennial Bikeway upgrade, architecturally designed parks, Velo Café and amenity block (started March 2021)
  • Heritage base works including structural support work (started August 2021)
  • Tower 5 Precinct early works (started July 2022)

Destination Brisbane currently has three contractors engaged – Multiplex, Fitzgerald and Delta Group.

Multiplex is responsible for the main integrated resort development and public realm works along the Bicentennial Bikeway and Queens Wharf Rd and Fitzgerald is responsible for the Neville Bonner Bridge construction.

Standard construction hours are from 6.30am to 6.30pm Monday to Saturday. Currently, Multiplex is approved to undertake night works (excluding Friday and Saturday nights) and outside these hours construction notices are issued and uploaded to the website under construction.

To stay informed about the project and construction activities please subscribe to our monthly e-newsletter or sign-up for construction updates by following the stay informed tab at the top of this page.

Destination Brisbane Consortium is excited to be building this transformational city changing project for Brisbane and we thank the community for their patience while this work is undertaken.

For general enquiries please contact the Consortium direct on 1800 104 535 or email qwbenquiries@destinationbrisbane.com.au.

Slide through to see Queen’s Wharf Brisbane evolve

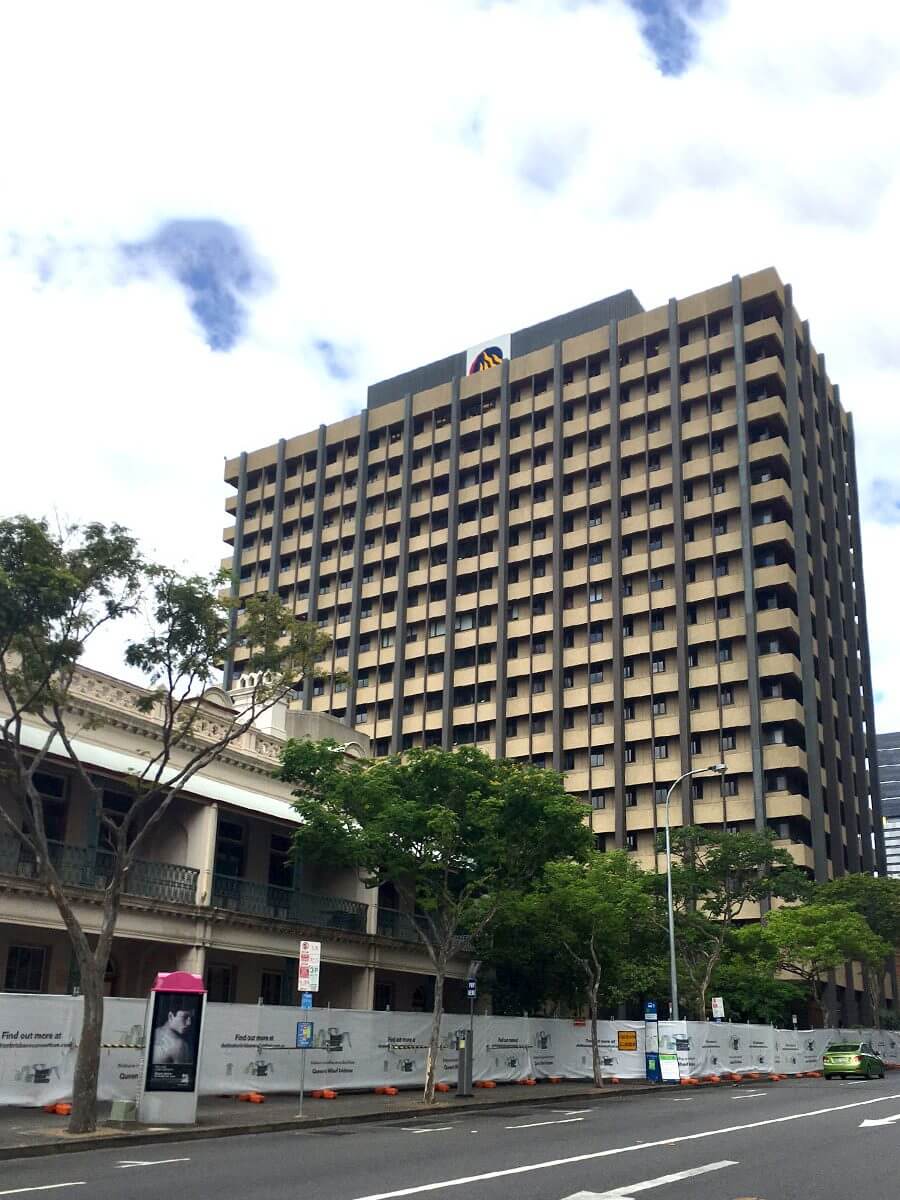

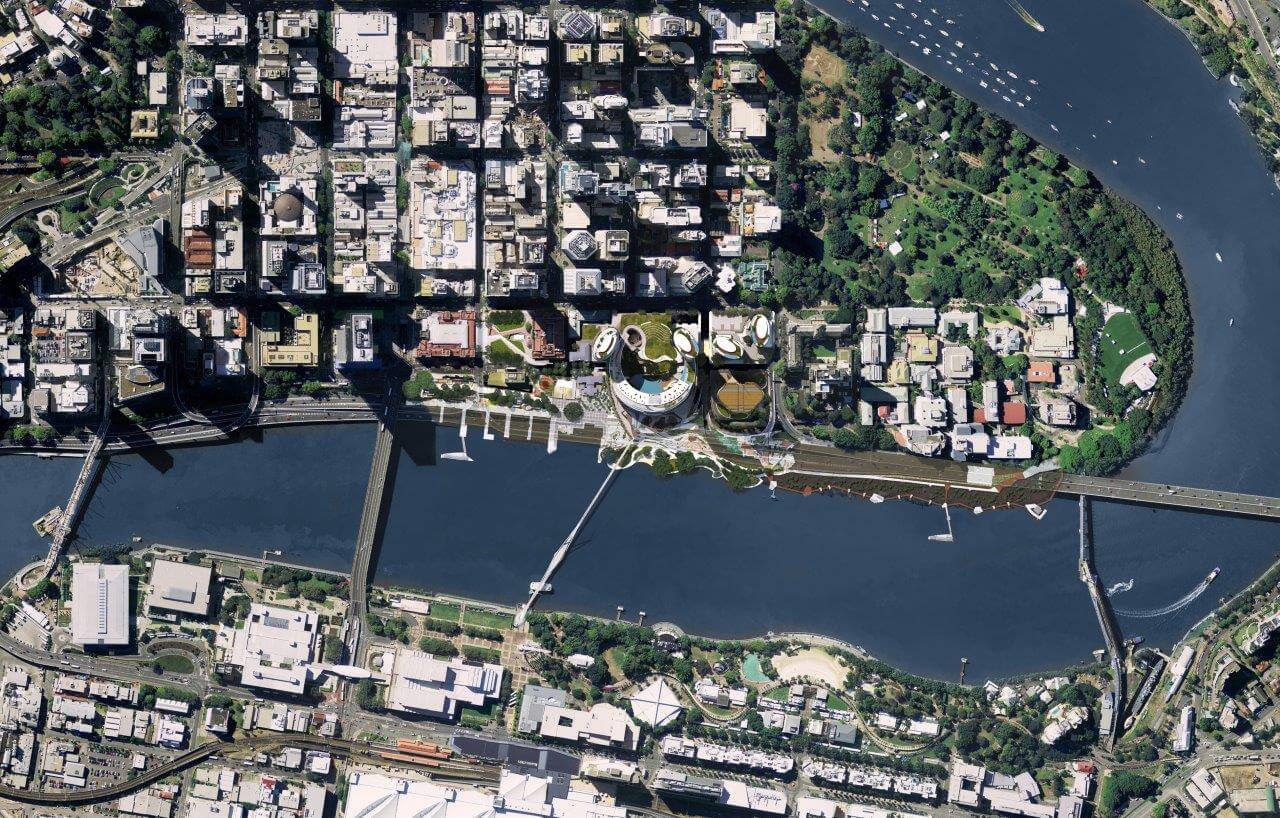

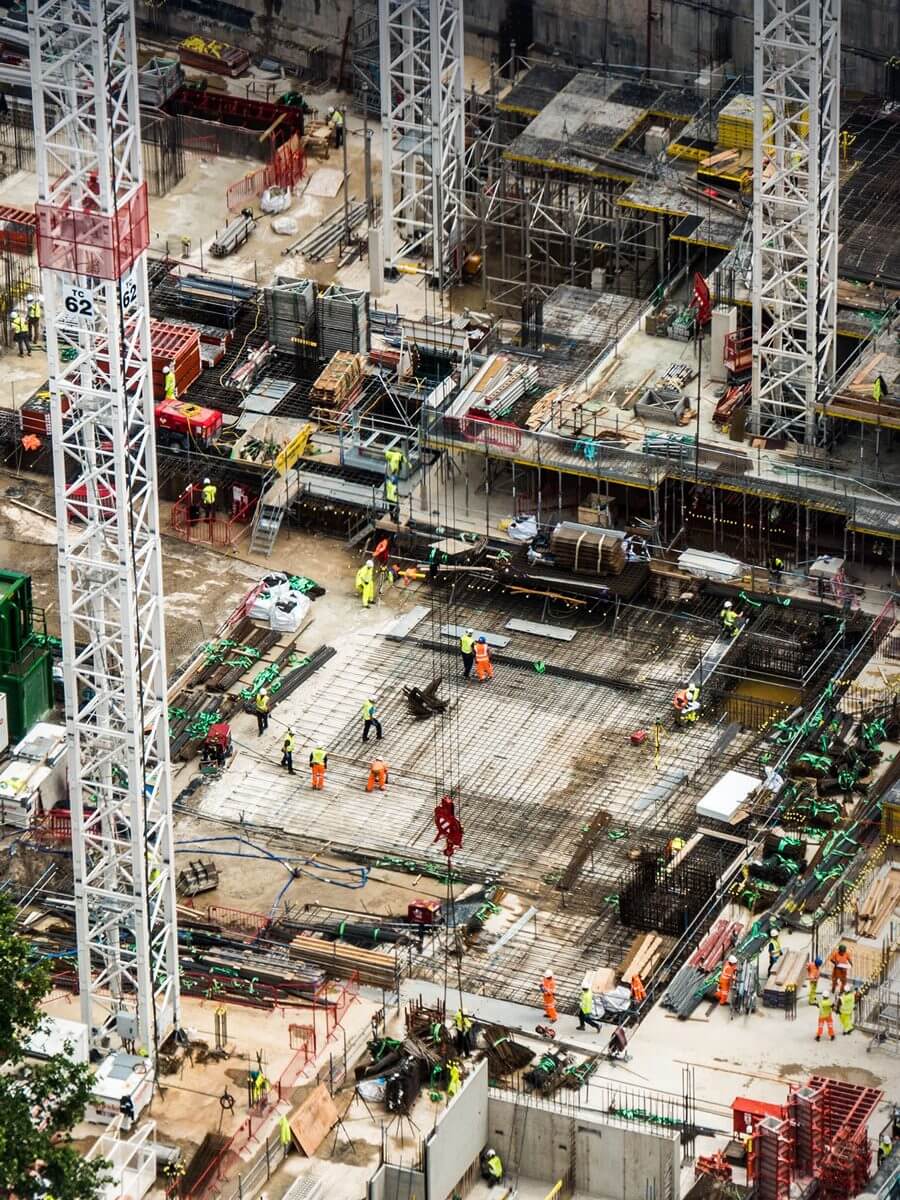

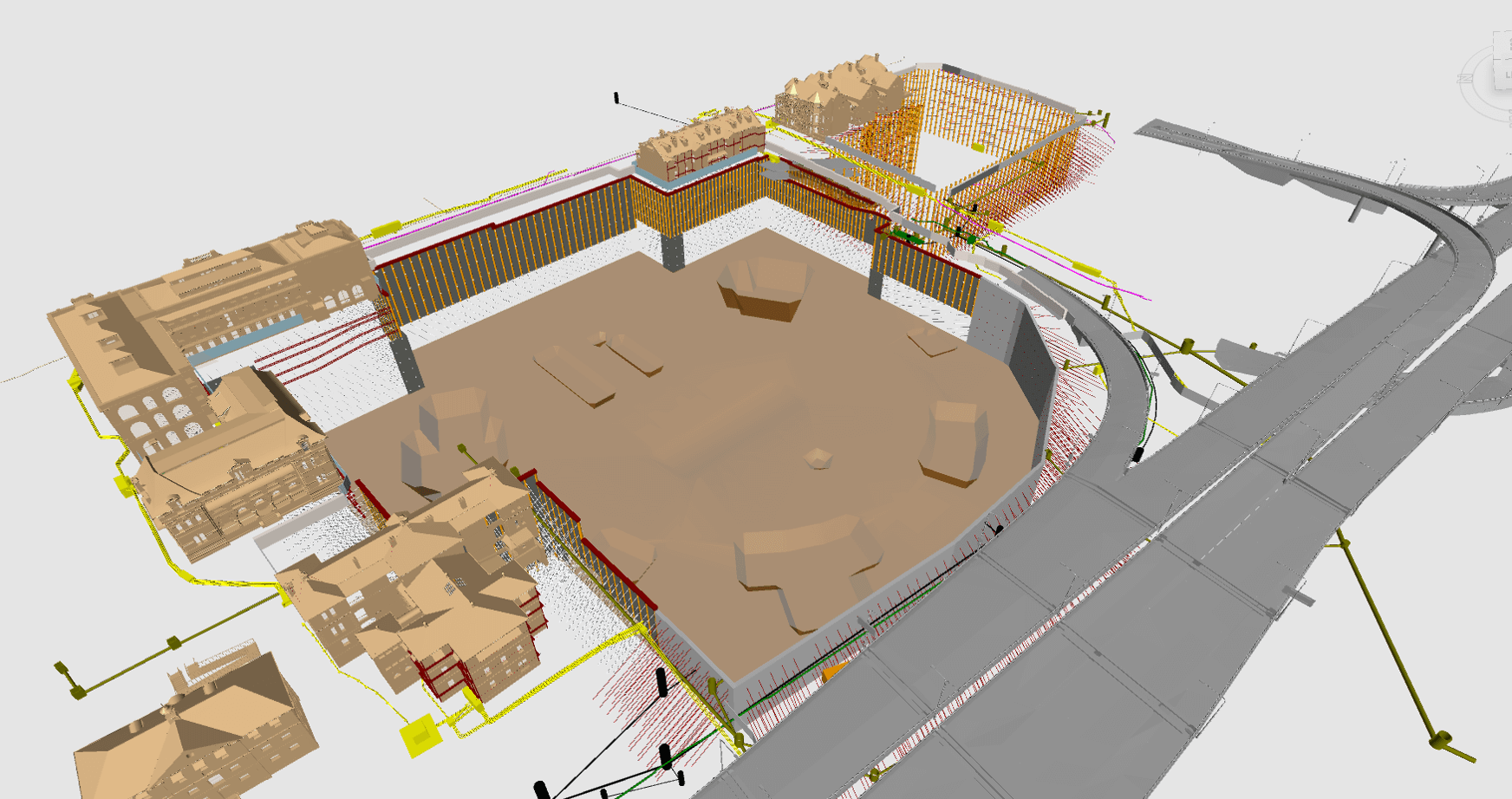

Construction March 2022

Construction Updates

  1. In Progress

    Temporary footpath closure on George Street

    From Monday 1 August 2022 a temporary footpath closure on George Street adjacent to the Treasury Hotel will be required while works to upgrade the pavement and street scape commence. When: From Monday 1 August 2022 for six weeks the footpath outside the Treasury Hotel will be temporarily closed to accommodate works to upgrade the […]
  2. In Progress

    Temporary road closure on George St between Margaret and Mary Streets

    On Saturday 13 August a temporary traffic detour to remove a tower crane from the Queen’s Wharf site will be required (rescheduled from 23 July). When: Works are scheduled on Saturday 13 August 2022 from 6.30am and 6.30pm requiring an exclusion area on George Street while works to remove a tower crane occur. A temporary […]
  3. In Progress

    Temporary footpath closure on George Street

    From Monday 20 June 2022 a temporary footpath closure on George Street adjacent to the Treasury Hotel will be required while works to upgrade the pavement and street scape commence. When: From Monday 20 June 2022 to late this year the footpath outside the Treasury Hotel will be temporarily closed to accommodate works to upgrade […]
  4. In Progress

    Bicentennial Bikeway diversion adjacent to Queen’s Wharf site

    From Tuesday 24th May 2022, a diversion for pedestrians and active transport users along the Bicentennial Bikeway will be required onto The Landing while works to upgrade public space adjacent to the Queen’s Wharf site occur. When: From Tuesday 24th May 2022, the diversion will be in place for pedestrians and active transport users on […]
  5. In Progress

    Extended night works: Structural steel with exclusion zones

    Night works will continue to 30 September 2022, five nights a week. For safety reasons large exclusion zones are required for these works when minimal workers are on-site. When: Night works are scheduled from 6.30pm to 5.30am Monday to Friday nights to 30 September 2022. These works are in addition to the standard site hours […]
  6. In Progress

    Stephens Lane to close to pedestrian and vehicular access

    From 21 June 2021 Stephens Lane will be closed for vehicle and pedestrian access. It will reopen as a walkway in late-2022 with the integrated resort development. When: From Monday 21 June 2021 until late-2022 Stephens Lane will be closed to vehicle and pedestrian access, becoming a construction zone for heritage building works and resurfacing. […]
  7. In Progress

    Construction zone extending to include Miller Park and Queens Wharf Road – no pedestrian access allowed

    From Monday 22 March 2021 Miller Park and Queens Wharf Road will be fenced and closed for public access while construction works are underway. Please use alternative routes. When: From 22 March 2021 until late-2022 Miller Park and Queens Wharf Rd will be under construction as part of Queens Wharf Brisbane public space upgrades. Work […]
  8. In Progress

    Construction zone to include Queens Wharf Road – no motorcycle parking permitted

    From Tuesday 2 March 2021 construction will begin along Queens Wharf Rd. Motorcycle parking will be removed progressively from this date. Access maintained for authorised vehicles only. When: From Tuesday 2 March 2021 until late-2022 construction will occur along Queens Wharf Road and the Bicentennial Bikeway. Work hours will be Monday to Friday 6.30am to […]
  9. In Progress

    Site establishment at South Bank for bridge

    On Monday 2 March Fitzgerald Constructions Australia will start early works at South Bank to enable the start of construction on the Neville Bonner Bridge. When: From Monday 2 March 2020, approved early works will begin at South Bank for construction of the Neville Bonner Bridge that will connect South Bank and the CBD at […]
  10. In Progress

    Temporary traffic changes to part of George Street (between Mary and Margaret Streets)

    From Monday 26 August 2019 materials will be lifted from trucks on George Street into the Queen’s Wharf construction site. For safety reasons, temporary traffic holds will be required on George Street. When: From Monday 26 August 2019, tower crane lifts will occur intermittently between 6.30am and 6.30pm Monday to Friday, and some Saturdays, requiring […]
